CBD ConsultantsCivil Engineering & Construction
Project Status Portal
Live delivery update

Sandy Creek Bridge Replacement

Delivered by CBD Consultants for Etheridge Shire Council
Reporting period  September 2026
Contract  ESC2025-019
Last updated  14/09/2026
Overall status
On Track
Out of the ground. Headstocks finishing for pour this week. Abutment fill arriving today. Beams in fabrication, delivery around 20 October.
Works complete
52%
Value of work certified to date (Claim 4, $1,440,651 ex). Substructure and pile caps. Piling done.
Forecast completion
Nov 2026
Contract date for Practical Completion remains 28 November 2026. Programme is beam-driven from delivery around 20 October.
Days LTI-free
84
From site mobilisation 22 June 2026, as at 14 September.
Delivery health

How the project is tracking

Programme
On track

Piling complete and verified. Pile caps done. Pier columns done. Headstocks completing for pour this week. Abutment fill arriving on site today. Beams in fabrication, delivery around 20 October. Programme is beam-driven from here.

Quality
Conforming

ITP register running live in Procore for Superintendent sign-off. Headstock pre-pour hold point scheduled Tuesday 15 September. Abutment pre-pour hold point booked for 28 September. Bridge bearings in manufacture in Malaysia, delivery to Georgetown expected in October.

Safety
No incidents

No incidents or near misses this period. Daily toolbox talks and sign-ons completed and audited. An independent safety and environmental audit is planned around beam placement in mid to late October.

Environment
Compliant

Erosion and sediment controls in place. No environmental events this period. Dewatering and spoil management actively controlled ahead of the pour.

Community
Active

Road remains closed to through traffic. Detour signage maintained on both approaches. No open community enquiries. Council's Mayor and Director visited site and noted good progress.

This period: August to September 2026

Progress & achievements

Headstocks are completing and will pour this week. Abutment fill is arriving on site. The bridge is out of the ground and substructure is well advanced. Work off site continues in parallel: precast beams are in fabrication, bearings are in manufacture in Malaysia, and deck and barrier steel is on order. Beam delivery around 20 October is the critical date the rest of the programme runs off.

  • All eight bored piles drilled, verified and poured. Pile caps done.
  • Pier columns done. Two piers topped out.
  • Headstock reinforcement in place, ready for pre-pour inspection Tuesday 15 September.
  • Abutment fill material arriving by road train today and tomorrow. Three more loads expected this week.
  • Rock protection geotextile and rock on site ready for placement beneath the bridge ahead of beam erection.
  • Precast girders in fabrication with Holcim. Beam delivery to Georgetown expected around 20 October.
  • Bridge bearings in manufacture in Malaysia, delivery to Georgetown expected October.
  • Deck steel, handrails and guardrails on order, due on site before beam installation.

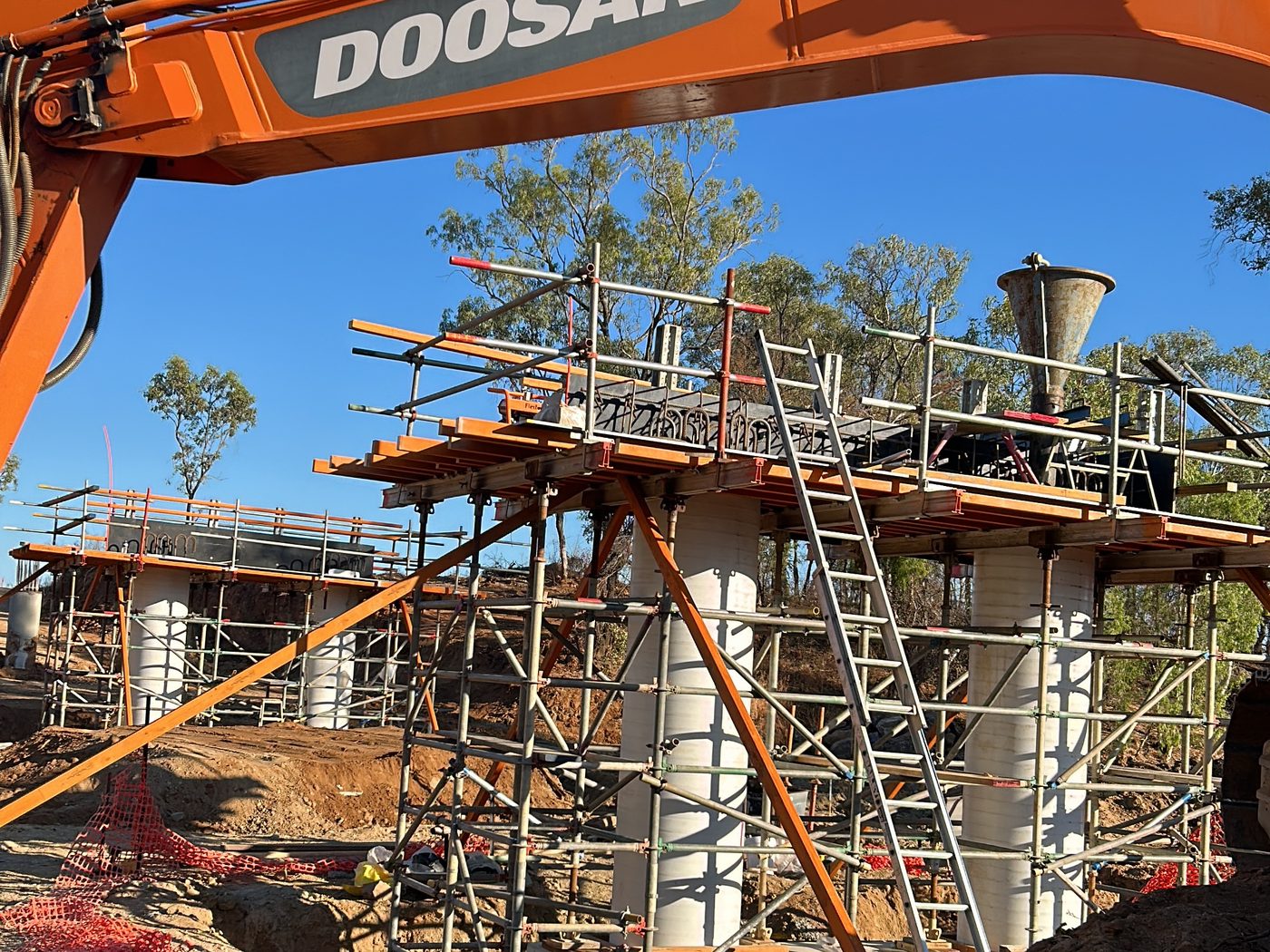

Pier columns complete with headstock formwork and reinforcement in place
Pier columns complete, headstocks formed and reinforcedSite · 8 Sep 2026

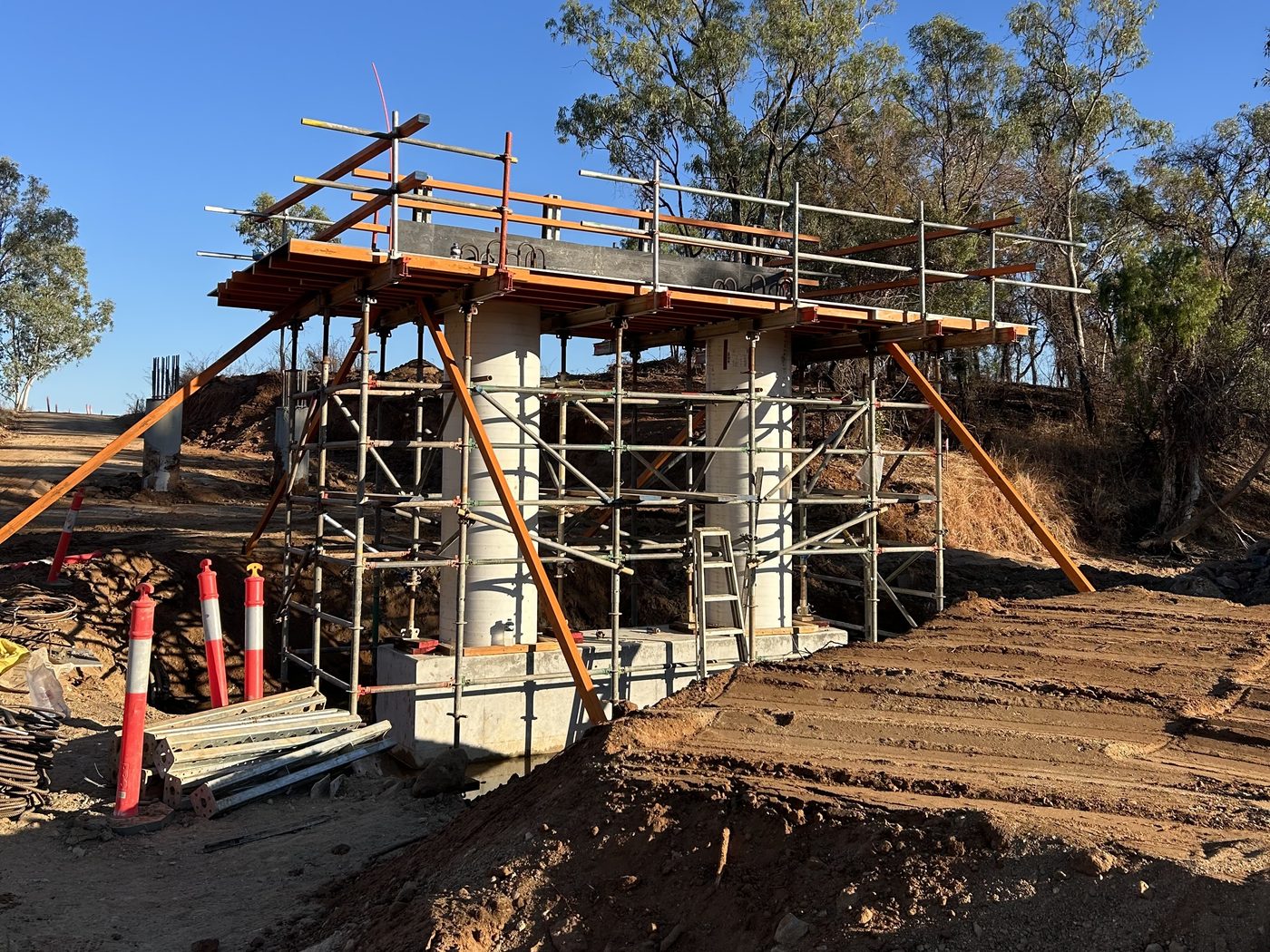

Headstock formwork and edge protection ready for the concrete pour
Headstock formwork closed up ahead of the pourSite · 8 Sep 2026

Piling rig set up on the creek bed at Sandy Creek
Piling rig working the creek bedSite · 23 Jul 2026

Tungsten carbide drill tooth worn down in the harder rock
Drill tooth worn through in the harder rockSite · 23 Jul 2026
Programme

Key milestones

18 May to 17 Jul 2026
Pre-construction, mix designs, shop drawings and site establishmentComplete
6 to 17 Jul 2026
Causeway demolition and bulk earthworksComplete
13 Jul to 1 Sep 2026
Piling: 8 bored piles drilled, verified and pouredComplete
2 to 11 Sep 2026
Pile caps and pier columnsComplete
Week of 15 Sep 2026
Headstocks: pre-pour inspection Tuesday, pour this weekIn progress
14 to 29 Sep 2026
Abutments: fill, formwork, reinforcement, concrete and rock protectionUpcoming
~20 Oct 2026
Precast beam delivery to Georgetown siteUpcoming
~21 to 22 Oct 2026
Bearings set and precast girders erected across all three spansUpcoming
Late Oct to Nov 2026
Bridge deck, barriers, expansion joints, surfacing and completionUpcoming
Next two weeks

Upcoming works & impacts

What residents and stakeholders can expect over the next two weeks.

Headstock pre-pour inspection (hold point) and concrete pour
15 Sep 2026
Abutment fill placed and compacted from road-train delivery
15 to 18 Sep 2026
Rock protection placed beneath bridge ahead of beam erection
Week of 22 Sep 2026
Abutment pre-pour inspection (hold point)
28 Sep 2026
Abutment concrete placement
29 Sep 2026
Safety & environment

Snapshot

84
Days LTI-free
From 22 June 2026, as at 14 September
0
Incidents & near misses
None recorded this period
Daily
Toolbox talks & sign-ons
Completed and audited every working day
0
Environmental events
None reported this period
Community & business

Engagement

Notifications issued1
Enquiries received0
Target response time24 hours
Open matters0

Get project updates

Residents and business owners can register to receive notifications about upcoming works, road closure dates and access changes.

Register for updates →
